Land & Development

Construction Tree Protection

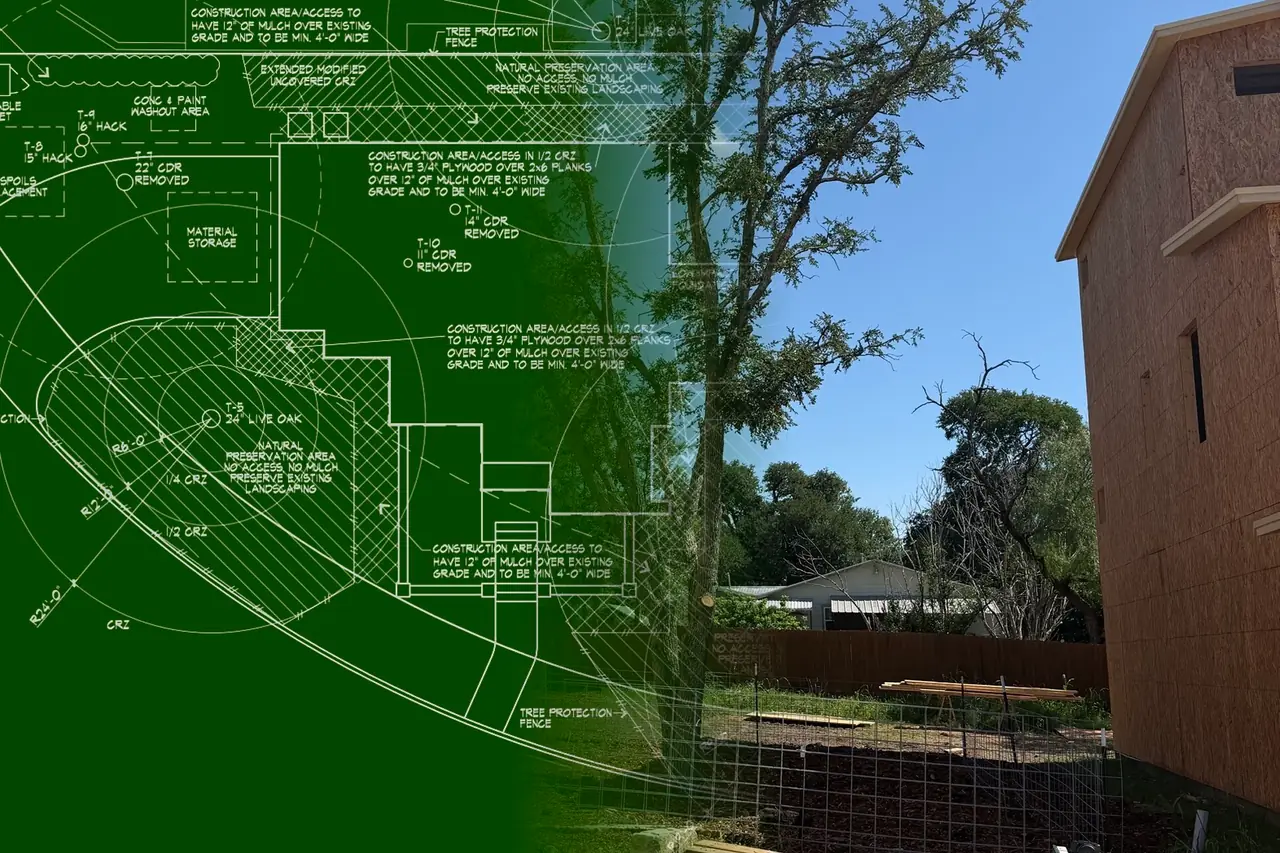

A tree protection plan drawing on the left dissolving into a photograph of the work built: wire protection fencing around a mulched root zone at the base of a cedar elm, framed and sheathed houses either side

Construction site tree protection in Austin is very involved. Knowing how to satisfy local ordinances plus doing what is right by the trees can become complicated. Doing a good job at this can save you money and result in beautiful trees at the end of your construction project. Austin Tree Experts excels at all phases of construction site tree protection services. When you hire us to evaluate the site, help with the tree protection planning and execute the tree protection measures, there is never confusion about who is responsible for it being correct.

Tree Ordinance Compliance & Planning

Tree ordinance compliance in Austin is quite complicated. There are several rules to follow regarding what trees are protected, how much root zone is required to protect and how much pruning is allowed for preserved trees. Austin Tree Experts can help with preplanning assessments, tree protection planning during permitting and job site execution. We are the consultants you need.

Plan view of a lot with a front yard tree and a back yard tree, each 20 inches in trunk diameter, with three rings drawn around each trunk: the full critical root zone at 20 feet, the half CRZ at 10 feet and the quarter CRZ at 5 feet. Paving and the house are hatched where they fall inside a root zone; a wood deck on deck blocks reaches into the back tree's quarter CRZ with no blocks inside it. Beside it: one inch of trunk diameter equals one foot of CRZ radius; keep development outside the half CRZ; keep 50 percent or more of the CRZ at natural grade (57 percent and 90 percent on this plan); what counts as a tree impact; and three design alternatives with small plans.

Rules and Definitions for Critical Root Zone Protection

Two 20″ trees on one lot, and the standard rules

Plan view of a lot drawn to scale: a street, sidewalk, driveway, house and wood deck, with a 20 inch front yard tree and a 20 inch back yard tree. Each tree has three rings, the full, half and quarter critical root zone; paving and the house are hatched where they fall inside a root zone, and the deck stands on blocks kept out of the back tree's quarter CRZ.
Left, the front yard tree; right, the back yard tree. Both are 20″, drawn to scale.

1″ of trunk diameter = 1′ of CRZ radius

Radius20″ tree
Full CRZDBH × 120′
½ CRZDBH ÷ 210′
¼ CRZDBH ÷ 45′

All three are drawn on the plans

Keep development outside the ½ CRZ

50% or more of the CRZ at natural grade

Front yard tree: 57%

Back yard tree: 90%

What counts as a tree impact

  • Paved driveways and sidewalks

    Impact

  • Anything with a roof

    Impact

  • Wood decks

    Not an impact (some special criteria required). The city counts piers and deck blocks as impacts, and bars them from the ¼ CRZ

Design Alternatives

Where a site can’t meet the standard rules

  • Small plan of a tree's three root zone rings with an existing structure reaching inside the quarter CRZ, shaded as existing and grandfathered.

    Existing structures within the ¼ CRZ

    Grandfathered

  • Small plan of a tree's three root zone rings, the band between the quarter and half CRZ tinted, with new building reaching into that band.

    Constrained sites

    May build between the ¼ and ½ CRZ. The 50% rule still applies

  • Small plan of a tree whose root zone is already more than half covered by existing structures. New work inside the existing coverage is marked with a check; new work extending onto uncovered ground is marked with a cross.

    Existing impacts over 50%

    Grandfathered. New work stays within the same coverage

  • Not entitled

    Alternatives generally require special construction techniques and permission from city arborist review staff.

Key

© Austin Tree Experts

  • Full CRZ
  • ½ CRZ
  • ¼ CRZ
  • Tree impact, inside the CRZ
  • Existing, grandfathered
  • Between the ¼ and ½ CRZ

Main plan drawn to scale: two 20″ trees

This drawing is meant to be a guide to help start tree evaluation and planning processes. Use of this detail is not a guarantee for permit or inspection compliance. We recommend you work with us on any construction site with trees for a comprehensive assessment.

Mulching & Tree Protection Fence

Tree protection requirements call for mulching, cladding tree trunks with 2x4 and tree protection fences. Sometimes plywood is required over the mulch to further buffer equipment traffic from causing soil compaction. Austin Tree Experts can make sure everything is done exactly the way it’s supposed to be.

Cross-section of a tree beside a house under construction. A chain link fence on T-posts wraps the critical root zone behind the tree, the trunk is clad in 2x4 lumber, existing vegetation inside the fence is left unmulched and bare ground gets 3 to 4 inches of mulch. Between the fence and the house, a 5 foot access zone gets 10 inches of mulch with plywood on top. Two close-ups show the ground cover inside the fence and the mulch depths either side of the fence line.
Cross-section of a tree beside a house under construction, with lettered badges: the chain link protection fence, the trunk clad in 2x4 lumber, existing vegetation inside the fence, mulched bare ground, and the construction access zone between the fence and the house, mulched and covered with plywood.
  • A: Tree protection fence

    Installed as drawn on the plans

  • B: 2x4 lumber cladding

    When the fence is 6′ or less from the tree

  • C: Existing vegetation cover

    No mulch required

  • D: Bare ground

    Gets 3–4″ of mulch

  • E: Construction access

    Next to a proposed structure, 5′ may be left between the house and the fence. Outside the fence, inside the CRZ: always 10″ of mulch. Plywood on top only if equipment will drive over it

The tree side of the section, with lettered badges: the chain link protection fence, the trunk clad in 2x4 lumber, existing vegetation inside the fence and mulched bare ground.
  • A: Tree protection fence

    Installed as drawn on the plans

  • B: 2x4 lumber cladding

    When the fence is 6′ or less from the tree

  • C: Existing vegetation cover

    No mulch required

  • D: Bare ground

    Gets 3–4″ of mulch

The house side of the section: between the protection fence and the framed house, a construction access zone covered in a deep layer of mulch with plywood on top, marked with a lettered badge.
  • E: Construction access

    Next to a proposed structure, 5′ may be left between the house and the fence. Outside the fence, inside the CRZ: always 10″ of mulch. Plywood on top only if equipment will drive over it

Close-up of the ground inside the fence: native grasses and wildflowers with no mulch on the left, bare ground covered with a layer of wood chip mulch on the right.
Ground cover inside the fence
  • A: Existing vegetation cover

    No mulch required

  • B: Bare ground

    Gets 3–4″ of mulch

Close-up at the fence line: a green T-post driven through the mulch with chain link wired to it. Inside the fence a thinner layer of mulch; outside, a much deeper layer with plywood on top.
At the fence line
  • A: Inside the fence

    3–4″ of mulch

  • B: Outside the fence, inside the CRZ

    Always 10″ of mulch. Plywood on top only if equipment will drive over it

Key

© Austin Tree Experts

  • Mulch
  • Plywood
  • Protection fence

Not to scale: mulch drawn thicker.

This drawing is meant to be a guide to help start tree evaluation and planning processes. Use of this detail is not a guarantee for permit or inspection compliance. We recommend you work with us on any construction site with trees for a comprehensive assessment.

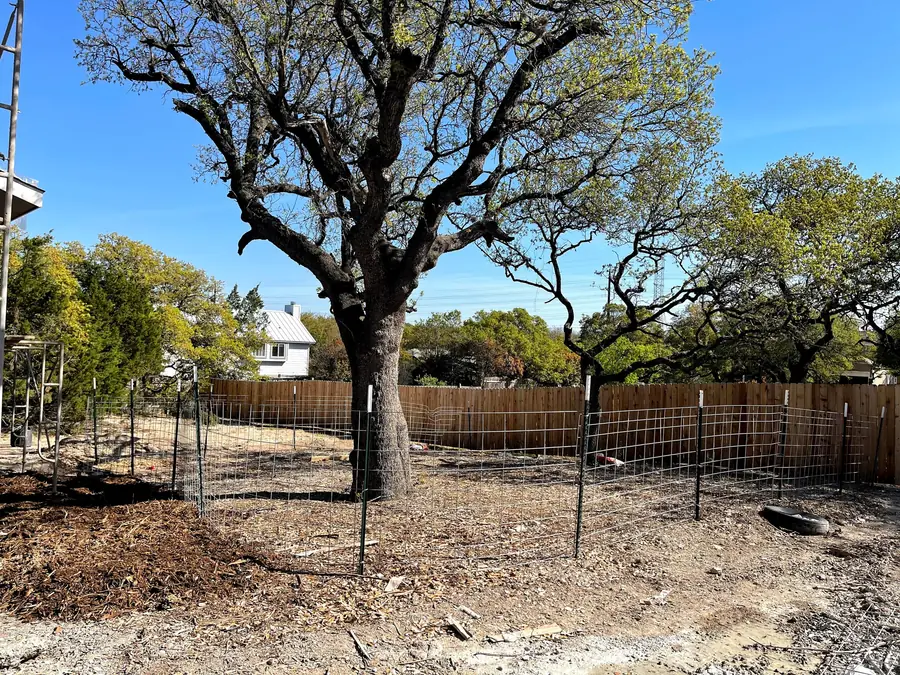

Welded wire fencing on steel posts enclosing a wide mulched area around a mature live oak on a cleared construction site

Tree Pruning and Removals

Tree pruning and removal are the core services provided by Austin Tree Experts. When we help develop the tree pruning plan and get the permits to remove trees, it’s only natural we execute the work to make sure things are done according to plan.

Airspading

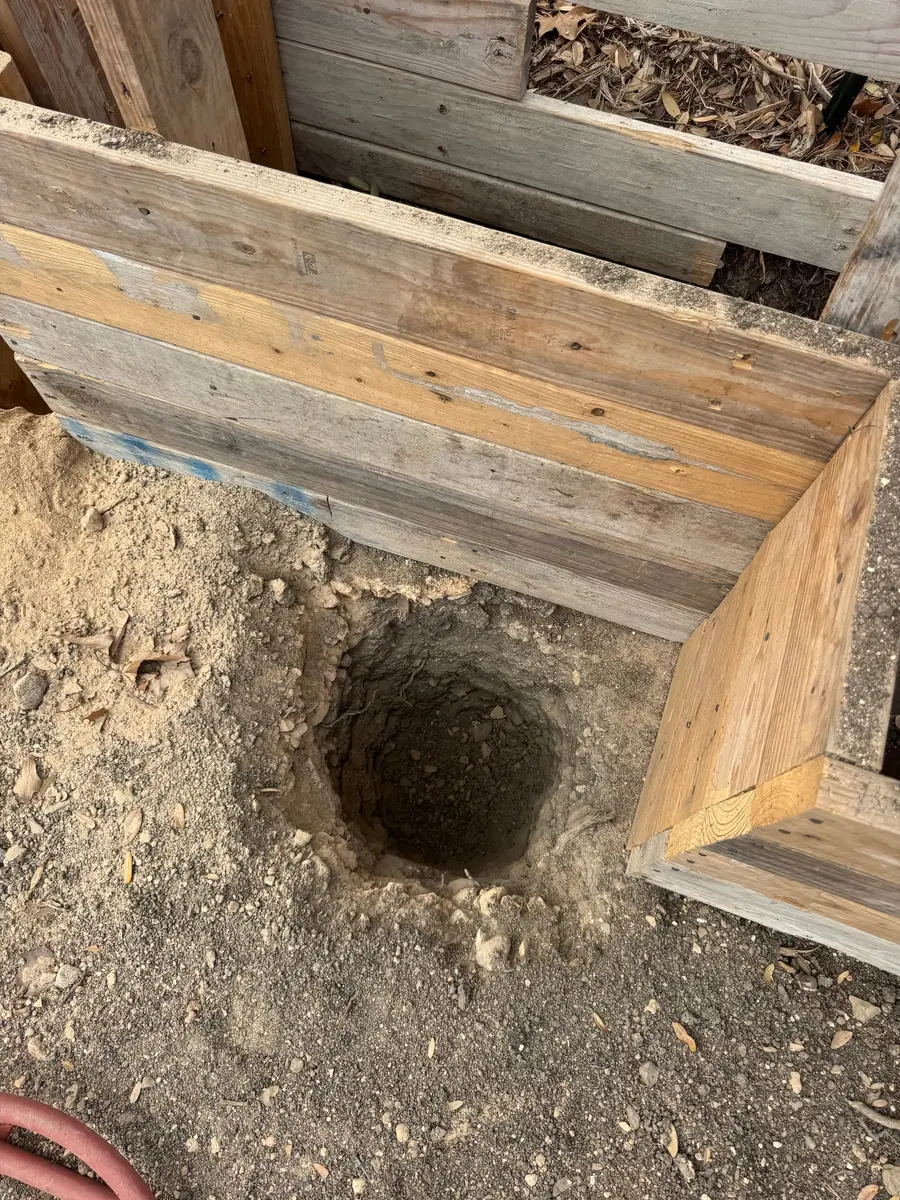

Most construction sites with trees will need airspading service for something: pier excavation within CRZs, utility trenching, soil decompaction, etc. Whether it’s one small pier that just needs one airspade tech or 80′ of trench where we put 4 guys on airspades simultaneously, we can get the work done quick and get out of your way.

Pier hole excavation with root protection measures construction site

Site Monitoring

Austin Tree Experts can provide periodic ongoing site inspections to help you know when tree protection measures get derailed. It’s better to stay ahead of this than wait for an inspector to drop a hammer on you.

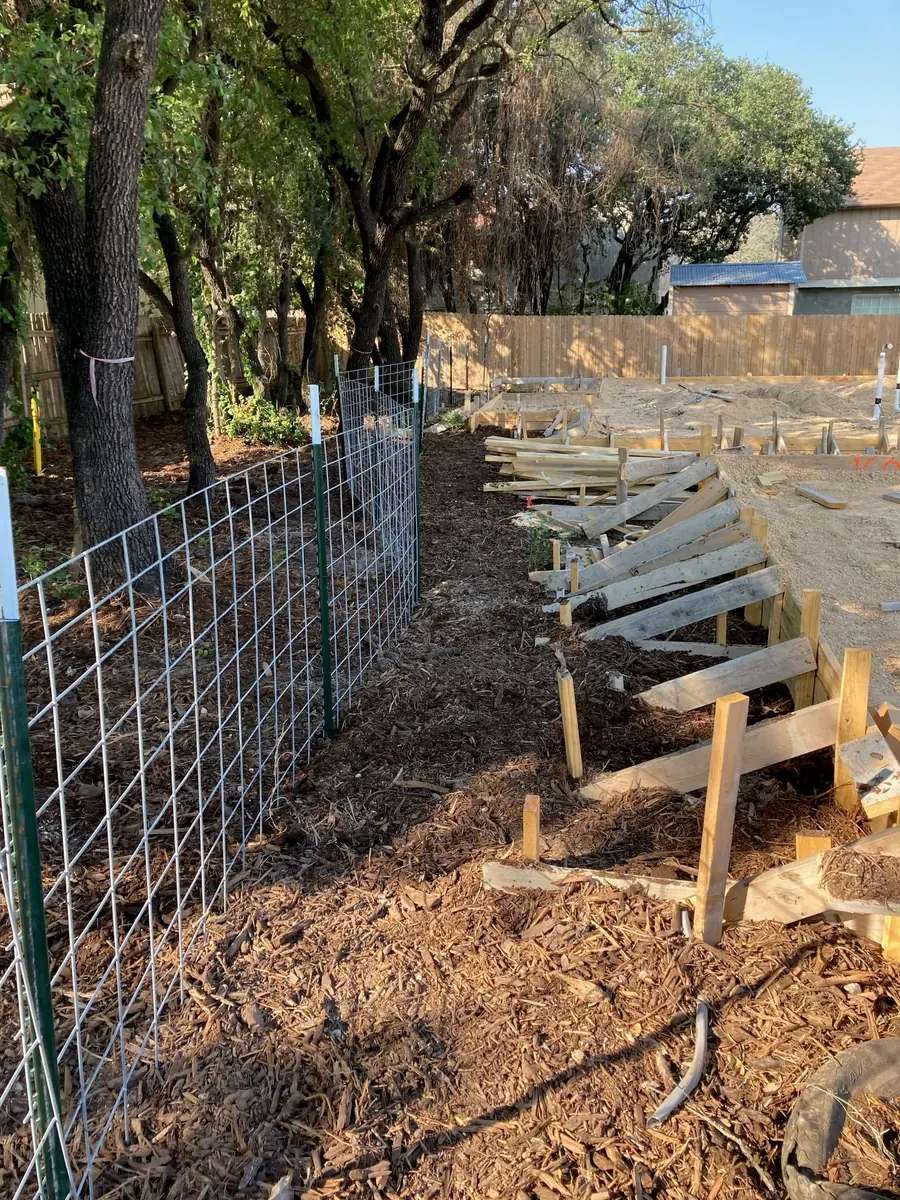

Welded wire tree protection fence on steel posts enclosing a mulched critical root zone, with foundation forms under construction beyond it

Mitigation & Post Construction Tree Care

Mitigation and tree care plans can take on different forms. Most construction sites will wind up with tree planting requirements or some tree care due to inadvertent mistakes throughout the construction process or as a part of a negotiated tree removal.

Construction Site Tree Services FAQs

Show 8 questionsHide questions
When should I bring an arborist onto a construction project?

During design, if you have the choice. That is when moving a driveway or a pier line is still a change to a drawing rather than a change to a build, and it is when we can tell you which trees are protected, which ones the design is going to conflict with, and what the permit is going to ask for. We are useful after ground breaks too, and a lot of our construction work starts there, but the options are narrower once the machines are on site.

Do you write the tree protection plan?

No, and it is worth knowing why. What a jurisdiction accepts as a tree protection plan is the protection measures drawn onto the building plans by the design team, not a separate arborist document sitting beside them. What we do is audit that plan set against the trees actually standing on the site, tell the design team what needs correcting, and then install and maintain the measures in the field. That split is deliberate: the plan belongs to the people who can change the design.

Can you handle the tree permit application?

We prepare the arborist material an application needs and we file the application on your behalf. We do not represent you at the City. No variances and no appeals. Requirements are not uniform across the metro either, so the first thing to establish is which jurisdiction governs the parcel. Our Jurisdiction Finder covers the Central Texas municipalities we work in.

What is a critical root zone, and how big is it?

It is the area of soil around a tree that holds the roots the tree depends on, and it is the area a protection plan fences off. The size is set from the tree’s trunk diameter, but the rule that converts diameter to a radius is written by the jurisdiction, so the number is not the same everywhere and there is no single figure worth quoting. Check the rules for your parcel with the Jurisdiction Finder, and see the Austin tree ordinance for how the City treats protected and heritage trees.

Can you dig inside a protected root zone for utilities and pier holes?

Yes. We excavate with airspades, which move soil with compressed air and leave the roots standing, so a trench or a pier hole can go in with the roots exposed rather than torn out. Roots that genuinely have to be cut get cut cleanly at a chosen point. On pier holes, if we run into a root we can often relocate the pier a small amount, which is typically not a problem for the engineers drawing the plans.

Do you do tree surveys or tree inventories?

We audit tree surveys for accuracy of the tree data, and we perform tree inventories. We provide tree data in formats compatible with CAD and GIS software, so location, species, trunk diameter and condition go back to the design team as data they can bring into the plan set rather than as something a drafter has to retype. We also attend design meetings when needed.

Does mitigation always mean planting replacement trees?

Not always. Depending on the jurisdiction and on the tree, mitigation can be replacement planting, a fee paid in lieu of planting, or a combination of the two. Which options are open to a project is set by the rules governing the parcel, so that is the first thing to establish. Where planting is the answer, the replacements are ours to install and we would rather site them where they have room to grow than place them to satisfy a count.

Can I remove a protected tree, pay the fine and plant new trees?

Loosely speaking, not in Austin. The tree has to qualify for removal first. Only then are you told how many trees, if any, have to be planted. Mitigation fees and plantings are not levers you can pull to get a permit approved, and a project that plans around them as if they were is planning around something that is not there.
